Software Engineering

Unit 2 — Software Design & Project Management

📚 Chapters

🎨 Chapter 1 — Software Design
🎨 SOFTWARE DESIGN — MIND MAP
Design Process → Transform requirements into implementable structure
Modular Design → Break system into independent modules
Design Model → Data, Architectural, Interface, Component design
Documentation → Design specs, diagrams, comments
Approaches → Structured, Object-Oriented, Function-Oriented

1.1 What is Software Design?

📖 Definition: Software Design is the process of transforming user requirements into a suitable form that helps the programmer write code and implement the system. It's like creating a blueprint before building a house.
💡 Real-life Analogy:

Think of building a house:

  • Requirements: "I need a 3-bedroom house with a garden"
  • Design: Architect creates blueprints showing rooms, doors, windows
  • Implementation: Builders use blueprints to construct the actual house

Similarly, software design bridges the gap between what the user wants (requirements) and what developers build (code).

⚠️ Key Point: Good design = Easy to implement, test, and maintain. Bad design = Confusing code, bugs, wasted time.

1.2 Design Process & Concepts

📖 Design Process: A series of steps that software designers follow to create a well-structured system from requirements.
Step 1 — Understand Requirements:

Read and analyze what the user wants. Identify inputs, outputs, and main features.

Step 2 — Identify System Components:

Break the system into major parts (modules). Each module does one specific job.

Example: An e-commerce app has modules for Login, Product Catalog, Shopping Cart, Payment.

Step 3 — Define Module Interactions:

Decide how modules talk to each other. What data flows between them?

Step 4 — Design Data Structures:

Choose how data will be stored (arrays, databases, files).

Step 5 — Design Algorithms:

Write step-by-step logic for each module's functions.

Step 6 — Create Design Documentation:

Draw diagrams (flowcharts, UML) and write design specs so developers understand the plan.

Core Design Concepts:

✅ 1. Abstraction: Hide complex details, show only essential features.
Example: When you drive a car, you use the steering wheel (simple interface). You don't need to know how the engine works internally (hidden complexity).
✅ 2. Modularity: Divide system into small, independent modules.
Example: Netflix has separate modules for user login, video streaming, recommendations, billing.
✅ 3. Cohesion: How focused is a module? High cohesion = module does ONE thing well.
Example: A "Payment" module should ONLY handle payments, not user login.
✅ 4. Coupling: How dependent are modules on each other? Low coupling = modules are independent.
Example: If changing the "Login" module breaks "Payment" → High coupling (BAD). Modules should work independently.
✅ 5. Refinement: Start with high-level design, then add more details step-by-step.
Example: First design "E-commerce System" → Then break into "User Management," "Product Catalog" → Then break further into smaller functions.

1.3 Effective Modular Design

📖 Modular Design: The practice of breaking a large software system into smaller, manageable, and independent modules. Each module performs a specific function.
💡 Real-life Example — Building Blocks:

Think of LEGO blocks. You build a big structure by combining small independent blocks. Each block is separate but they fit together. If one block breaks, you replace only that block — not the entire structure.

Similarly, modular design lets you build, test, and fix one module without affecting others.

Benefits of Modular Design:

✅ Easier to Understand: Small modules are simpler than one huge program.
✅ Easier to Test: Test each module separately.
✅ Easier to Maintain: Fix bugs in one module without touching others.
✅ Reusable: Use the same module in different projects (e.g., a "Login" module can be reused in multiple apps).
✅ Parallel Development: Different teams can work on different modules at the same time.

Characteristics of Good Modules:

Characteristic What it means Example
High Cohesion Module focuses on ONE task "SendEmail" module only sends emails
Low Coupling Modules are independent Changing "Login" doesn't affect "Payment"
Clear Interface Easy to understand inputs/outputs calculateTotal(price, quantity) → returns total
Single Responsibility One reason to change "Payment" module changes only if payment logic changes
Notes Image

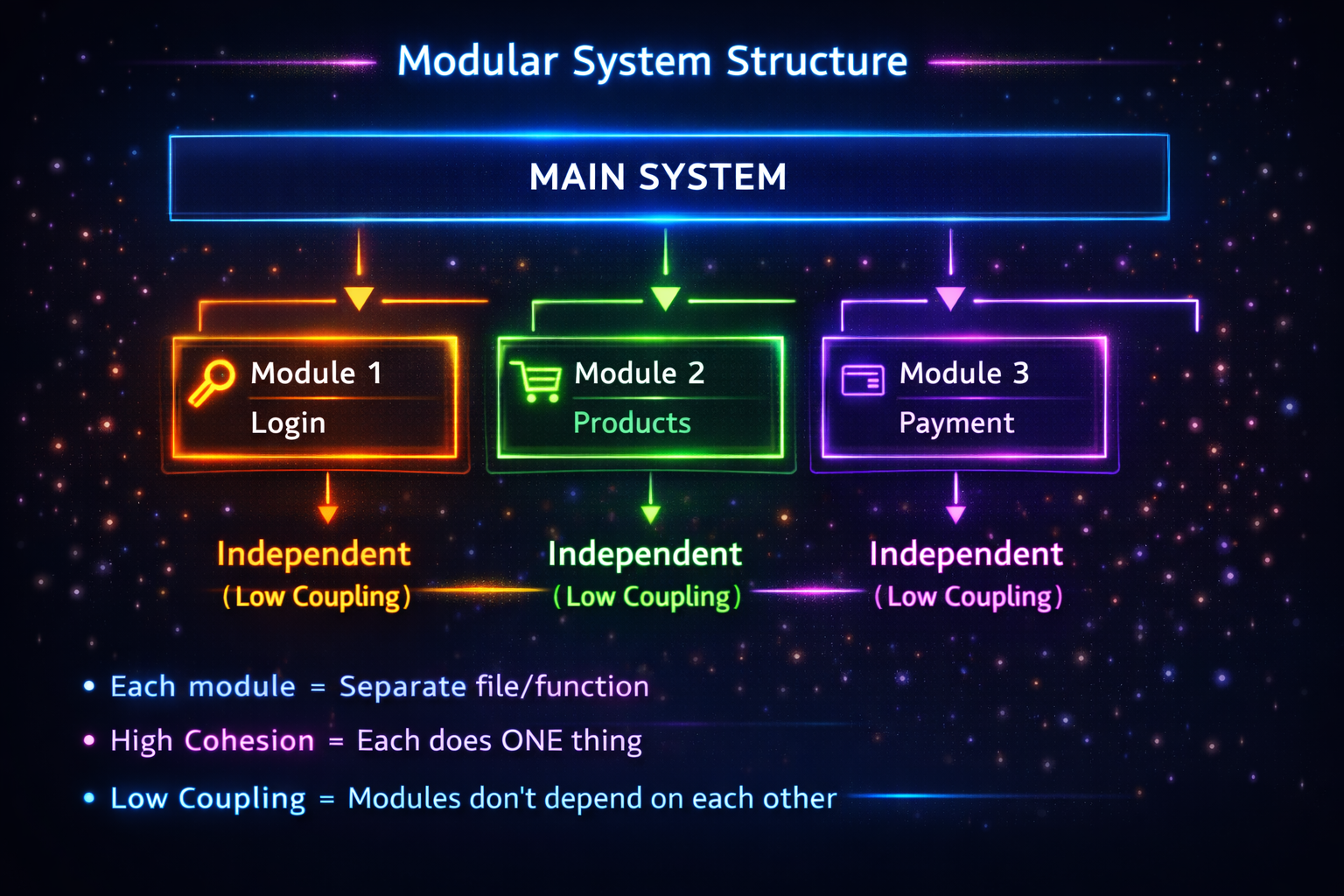

📊 Modular Design Structure

1.4 The Design Model

📖 Design Model: A collection of different design views that describe the software from multiple perspectives. It's like looking at a building from different angles — floor plan, electrical wiring, plumbing.

Types of Design Models:

1. Data Design (Database Design):

Focuses on HOW data is stored and organized.

  • What tables/collections are needed?
  • What relationships exist between data?
  • What are the primary keys?

Example: In an e-commerce app, design tables for Users, Products, Orders.

2. Architectural Design:

Shows the BIG PICTURE — overall structure of the system.

  • What are the main components?
  • How do they communicate?
  • Is it client-server? Microservices? Monolithic?

Example: "Frontend (React) talks to Backend (Node.js) which connects to Database (MongoDB)."

3. Interface Design:

Defines how modules/components interact with each other and with users.

  • User Interface: Screens, buttons, forms users see
  • Module Interface: Function signatures (inputs/outputs between modules)
  • External Interface: APIs, third-party services (payment gateway, Google Maps)
4. Component-Level Design:

Detailed design of EACH module — internal logic, algorithms, data structures.

Example: Design the "Login" module — what happens when user enters username/password? Check database, validate, create session, redirect.

Notes Image

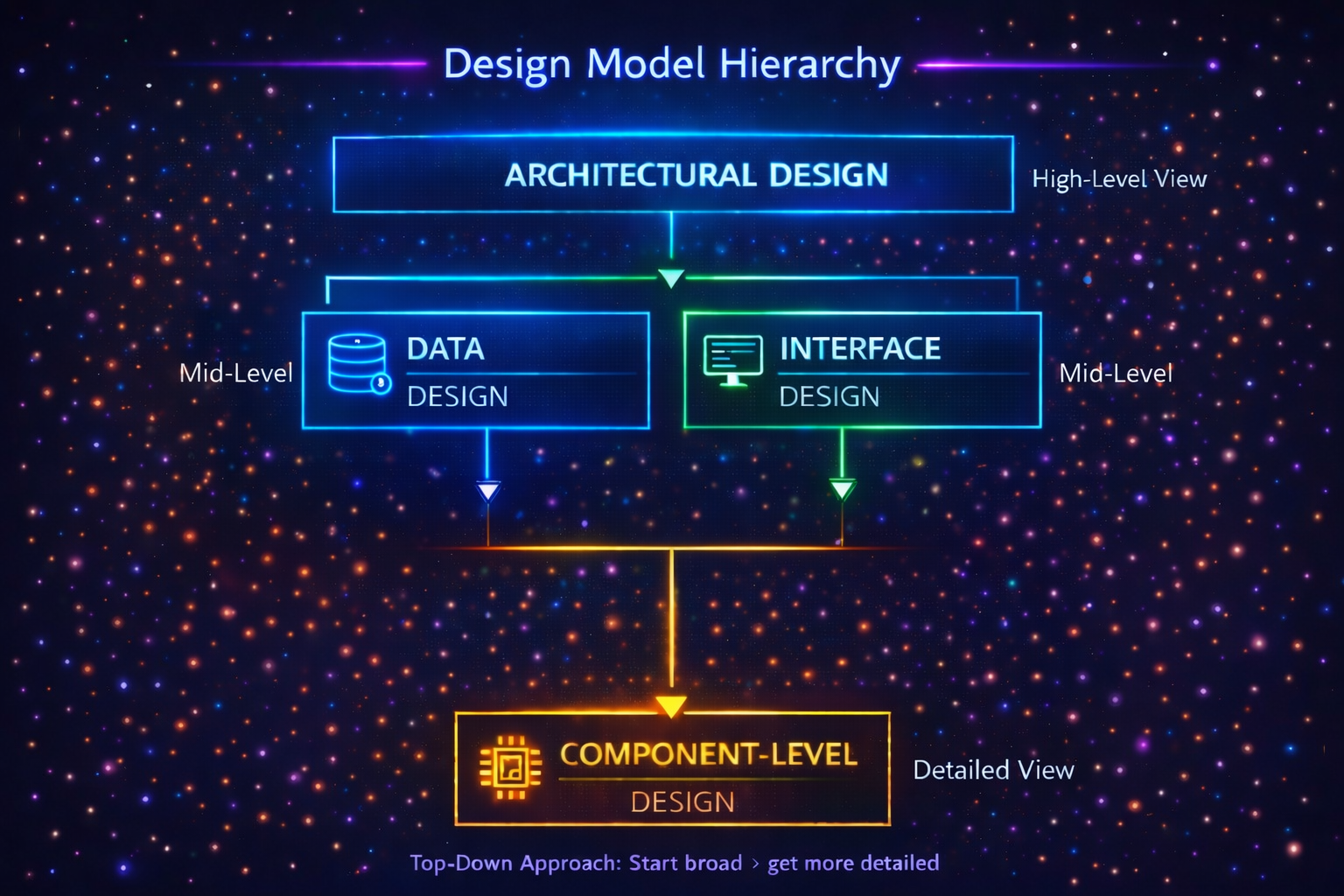

📊 Design Model Levels

1.5 Design Documentation

📖 Design Documentation: Written and visual materials that explain the design decisions, structure, and logic of the system. It helps developers, testers, and future maintainers understand the system.
💡 Why Documentation Matters:

Imagine joining a project 6 months after it started. Without documentation, you'd have NO IDEA:

  • Why certain design decisions were made
  • How modules connect to each other
  • What each function does

Good documentation = New team members can understand the system quickly.

What to Document:

✅ 1. Design Rationale: WHY did you make this design choice?
Example: "We chose microservices architecture because it allows independent scaling of different features."
✅ 2. Architecture Diagrams: Show system structure visually (UML, flowcharts, block diagrams).
✅ 3. Module Descriptions: For each module, explain:
• Purpose (What does it do?)
• Inputs/Outputs
• Dependencies (What other modules does it need?)
✅ 4. Interface Specifications: Document all APIs, function signatures, data formats.
✅ 5. Code Comments: Inside the code, explain complex logic.
Example: // Using binary search here for O(log n) performance
✅ 6. Design Constraints: Any limitations or requirements.
Example: "System must handle 10,000 concurrent users" or "Must work on mobile devices with slow internet."
❌ Common Documentation Mistakes:
  • Too much detail (nobody reads 100-page documents)
  • Outdated docs (docs don't match actual code)
  • No visuals (text-only is boring and hard to understand)
  • Technical jargon (explain in simple terms)
💡 Best Practice: Keep documentation SHORT, VISUAL, and UP-TO-DATE. Use diagrams wherever possible. Update docs when you change code.

1.6 Approaches to Software Design

📖 Design Approaches: Different methodologies or philosophies for structuring and organizing software systems.

Approach 1 — Structured Design (Function-Oriented)

Structured Design: Focus on FUNCTIONS and PROCEDURES. Break the system into functions that process data.

Characteristics:
  • Top-down approach (start with main function, break into smaller functions)
  • Data flows through functions
  • Uses flowcharts, DFD (Data Flow Diagrams)
Example: C programming — main() calls function1(), function2(), etc.
Good for: Small to medium projects, procedural programming.

Approach 2 — Object-Oriented Design (OOD)

Object-Oriented Design: Focus on OBJECTS (entities with data + behavior). System is a collection of interacting objects.

Core Concepts:
  • Class: Blueprint for objects (e.g., User class)
  • Object: Instance of class (e.g., user1, user2)
  • Encapsulation: Hide internal details, expose only necessary methods
  • Inheritance: Child class inherits properties from parent
  • Polymorphism: Same function name, different implementations
Example: Java, Python, C++ — define classes, create objects.
Good for: Large, complex systems that model real-world entities.

Approach 3 — Component-Based Design

Component-Based Design: Build system using pre-built, reusable components.

Characteristics:
  • Use libraries, frameworks, plugins
  • Components are like puzzle pieces — fit them together
  • Faster development (don't reinvent the wheel)
Example: Using React components, npm packages, third-party APIs.
Good for: Web apps, mobile apps where many ready-made components exist.
Approach Focus Example Language Best For
Structured Functions C, Pascal Small systems
Object-Oriented Objects/Classes Java, Python, C++ Large systems
Component-Based Reusable components React, Angular Web/Mobile apps
📊 Chapter 2 — Software Project Management
📊 PROJECT MANAGEMENT — MIND MAP
Project Planning → Define scope, objectives, resources, timeline
Estimation → LOC, Function Point, COCOMO models
COCOMO Model → Basic, Intermediate, Detailed — estimate effort & cost
Scheduling → Gantt charts, PERT, CPM — plan tasks & deadlines
Risk Management → Identify, analyze, mitigate risks
Quality Management → Standards, reviews, testing
Configuration Management → Version control, change management

2.1 Software Project Planning

📖 Definition: Software project planning is the process of defining the scope, objectives, resources, timeline, and budget for a software project. It's the roadmap that guides the entire development process.
💡 Real-life Analogy — Planning a Road Trip:

Before starting a road trip, you plan:

  • Destination: Where are we going? (Project goal)
  • Route: Which roads to take? (Project tasks)
  • Time: How long will it take? (Schedule)
  • Budget: How much money needed? (Cost)
  • People: Who's coming? (Team members)
  • Risks: What if car breaks down? (Risk planning)

Similarly, project planning prepares for software development journey.

Key Planning Activities:

1. Define Project Scope:

What features will be included? What's OUT of scope?

Example: "We'll build user login and product catalog. We WON'T build payment system in version 1."

2. Set Objectives & Goals:

What should the project achieve? Be specific and measurable.

Example: "Launch website by December 1st with 10,000 registered users in first month."

3. Identify Resources:
  • Human Resources: Developers, designers, testers, project manager
  • Technical Resources: Computers, servers, software licenses
  • Financial Resources: Budget for salaries, tools, cloud hosting
4. Create Work Breakdown Structure (WBS):

Break big project into smaller tasks.

Example: "Build E-commerce Site" → "Design UI" → "Create Homepage" → "Design Header" → "Add Logo"

5. Estimate Time & Cost:

How long will each task take? How much will it cost? (We'll learn estimation techniques next!)

6. Assign Responsibilities:

Who will do what? Clear roles prevent confusion.

✅ Why Planning Matters:
  • Prevents scope creep (uncontrolled feature additions)
  • Helps meet deadlines
  • Manages budget effectively
  • Team knows what to do and when
  • Stakeholders have realistic expectations
❌ Without Planning: Missed deadlines, budget overruns, confused team, unhappy clients, project failure.

2.2 Project Estimation Techniques

📖 Project Estimation: The process of predicting how much effort (time), cost (money), and resources (people) will be needed to complete a software project.
⚠️ Key Point: Estimation is NOT exact science. It's an educated guess based on experience and historical data. Estimates improve as project progresses.

Technique 1 — Lines of Code (LOC) Method

LOC Estimation: Estimate project size based on number of lines of code that will be written.

How it works:
  • Analyze similar past projects → Find average LOC
  • Estimate LOC for current project
  • Calculate effort: Effort = LOC / Productivity Rate
Example:
Past project: 10,000 LOC took 5 months
Productivity = 10,000 / 5 = 2,000 LOC per month
New project: 15,000 LOC estimated
Effort = 15,000 / 2,000 = 7.5 months
❌ LOC Problems:
  • Different languages have different LOC (Python vs Java)
  • Hard to estimate LOC before coding
  • Doesn't account for code quality
  • Encourages writing more code (not better code)

Technique 2 — Function Point (FP) Method

Function Point Estimation: Estimate based on FUNCTIONALITY delivered to user, not code size.

Count these components:
  • External Inputs: Forms, data entry screens
  • External Outputs: Reports, messages
  • External Inquiries: Search queries
  • Internal Files: Database tables
  • External Interfaces: APIs, third-party integrations
Each component gets a weight (simple/average/complex)
Calculate total Function Points → Use formula to get effort.
✅ FP Advantages: Language independent, focuses on user value, can estimate early in project.

Technique 3 — Expert Judgment

Expert Judgment: Ask experienced developers/managers to estimate based on their knowledge.

Delphi Technique:
  • Multiple experts give estimates independently
  • Facilitator shares all estimates anonymously
  • Experts discuss and revise estimates
  • Repeat until consensus reached
Good for: Novel projects with no historical data.

Technique 4 — Analogous Estimation

Analogous Estimation: Compare current project to similar past projects.
Example: "This e-commerce site is like the one we built last year. That took 6 months, so this should take around 7 months (slightly more complex)."
Technique Based On Advantage Disadvantage
LOC Lines of code Simple to calculate Language dependent
Function Point User functionality Language independent Complex to calculate
Expert Judgment Experience Good for new projects Subjective, biased
Analogous Past projects Quick, practical Needs similar projects

2.3 COCOMO Model (Constructive Cost Model)

📖 COCOMO Model: A mathematical model developed by Barry Boehm to estimate the effort, cost, and schedule for a software project. It uses project size (LOC) and other factors to calculate estimates.
💡 Real-life Analogy — Recipe Scaling:

If a recipe for 4 people needs 2 cups of flour, cooking for 8 people needs about 4 cups. But it's not exactly double — you might need slightly less (efficiency). COCOMO similarly scales effort based on project size with adjustments.

Three Levels of COCOMO:

1. Basic COCOMO:

Quick, rough estimate based ONLY on project size (LOC).

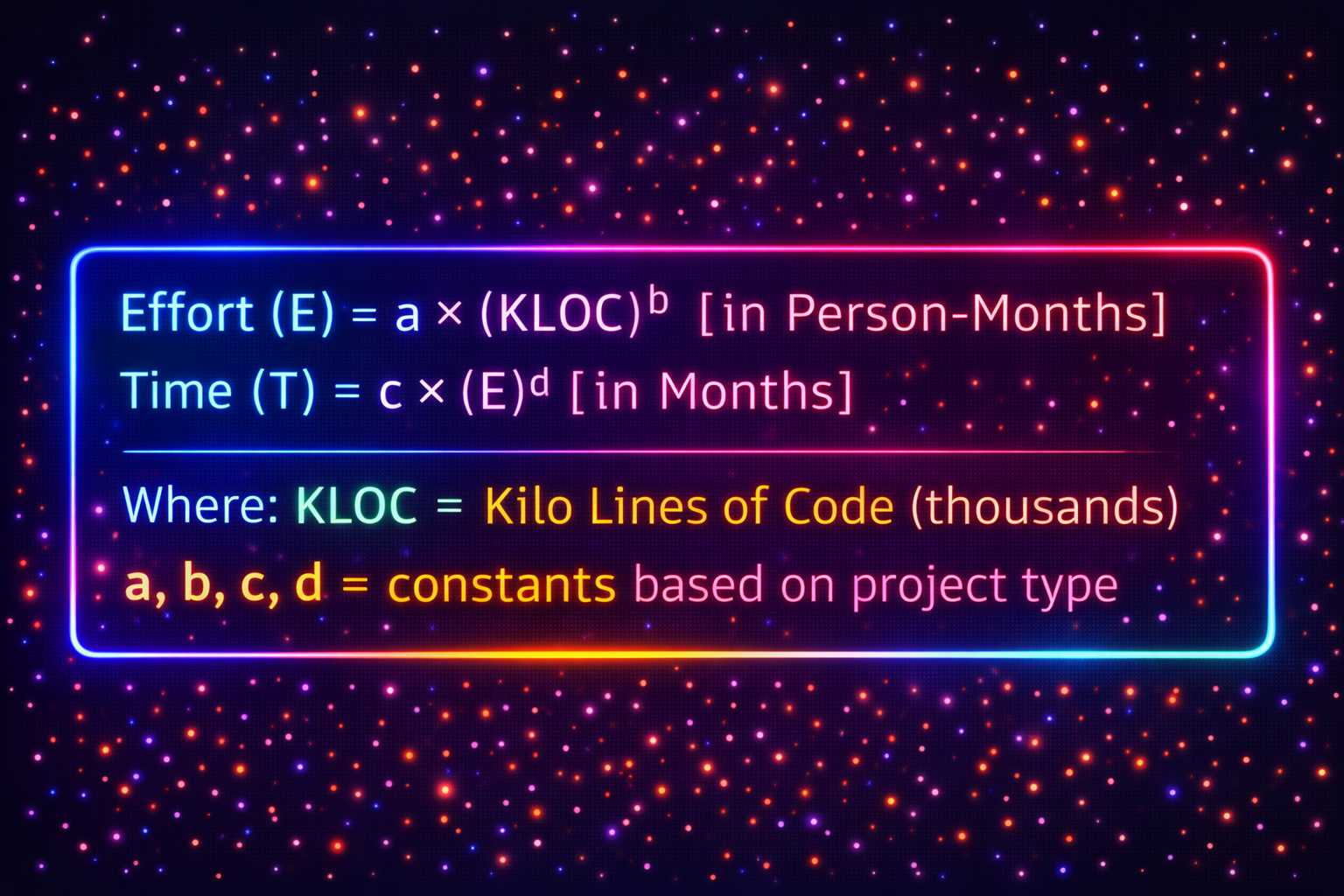

Basic COCOMO Formula
Project Type a b c d Example
Organic 2.4 1.05 2.5 0.38 Small team, familiar domain
Semi-detached 3.0 1.12 2.5 0.35 Medium team, some complexity
Embedded 3.6 1.20 2.5 0.32 Large team, hardware constraints
💡 Solved Example — Basic COCOMO:

Problem: Organic project with 20,000 LOC (20 KLOC). Calculate Effort and Time.

Solution:
Given: Organic → a=2.4, b=1.05, c=2.5, d=0.38, KLOC=20

Step 1: Calculate Effort E = a × (KLOC)^b E = 2.4 × (20)^1.05 E = 2.4 × 21.27 E = 51 Person-Months Step 2: Calculate Time T = c × (E)^d T = 2.5 × (51)^0.38 T = 2.5 × 4.29 T = 10.7 Months Step 3: Calculate Team Size Team = Effort / Time Team = 51 / 10.7 Team = 4.8 ≈ 5 people

Answer: 51 person-months effort, 10.7 months duration, 5-person team.

2. Intermediate COCOMO

Intermediate COCOMO:

More accurate than Basic. Uses 15 cost drivers (factors that affect effort):

  • Product attributes: Reliability, database size, complexity
  • Hardware attributes: Execution time, memory constraints
  • Personnel attributes: Experience, capability
  • Project attributes: Tools, schedule, methods

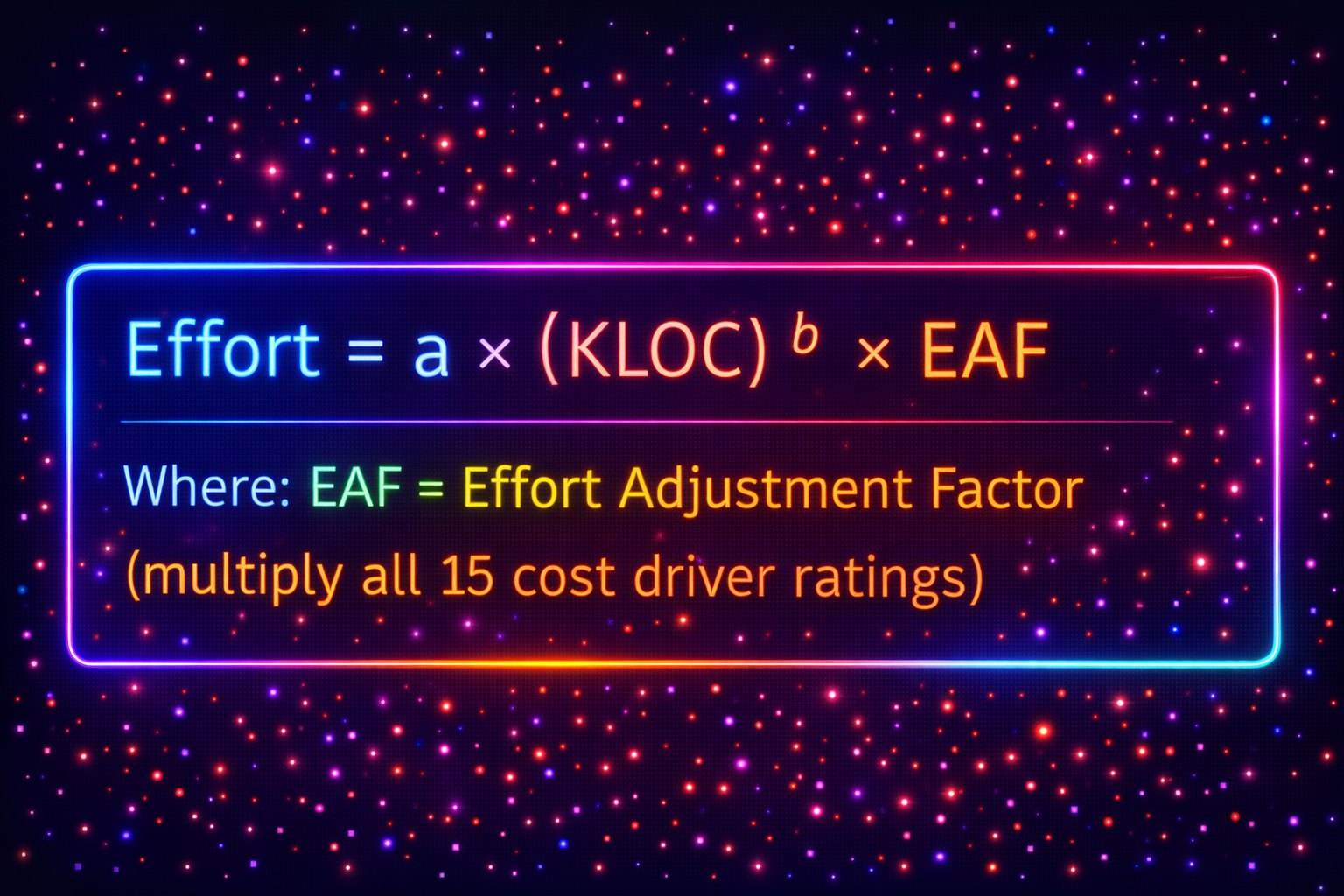

Intermediate COCOMO Formula

Each cost driver rated: Very Low, Low, Normal, High, Very High → assigned a multiplier.

3. Detailed COCOMO

Detailed COCOMO:

Most accurate. Considers cost drivers at each phase (requirements, design, coding, testing). Different multipliers for each phase.

Used for large, complex projects where high accuracy needed.

✅ COCOMO Advantages:
  • Widely used and validated
  • Mathematical basis (not just guessing)
  • Accounts for project complexity
  • Three levels for different accuracy needs
❌ COCOMO Limitations:
  • Needs LOC estimate (hard to get early)
  • Constants (a, b, c, d) may not fit your organization
  • Doesn't work well for modern Agile projects
  • Based on old data (1981 — before internet era)

2.4 Project Scheduling

📖 Project Scheduling: The process of defining tasks, assigning resources, setting start/end dates, and sequencing activities to complete the project on time.
💡 Real-life Analogy — Making a Meal:

Cooking dinner requires scheduling:

  • Chop vegetables (15 min) → Can do in parallel with boiling water
  • Boil water (10 min) → Must finish before adding pasta
  • Cook pasta (12 min) → Depends on boiling water
  • Prepare sauce (8 min) → Can do while pasta cooks

Some tasks can happen together (parallel), some must wait for others (dependencies). Project scheduling is the same!

Scheduling Tools:

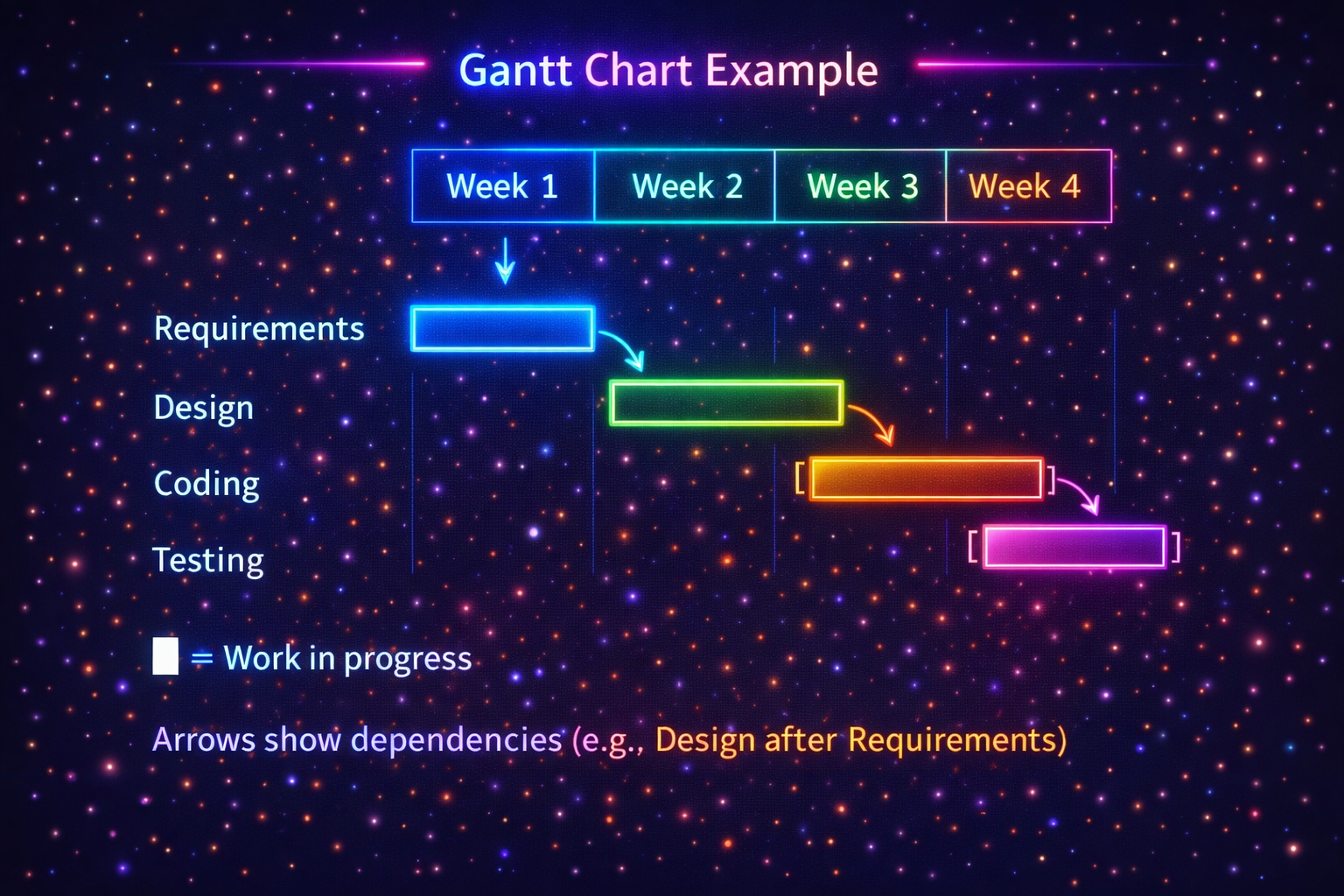

1. Gantt Chart:

A horizontal bar chart showing tasks on timeline. Each bar = one task. Length = duration.

Notes Image
📊 Gantt Chart

Good for: Simple visualization, tracking progress.

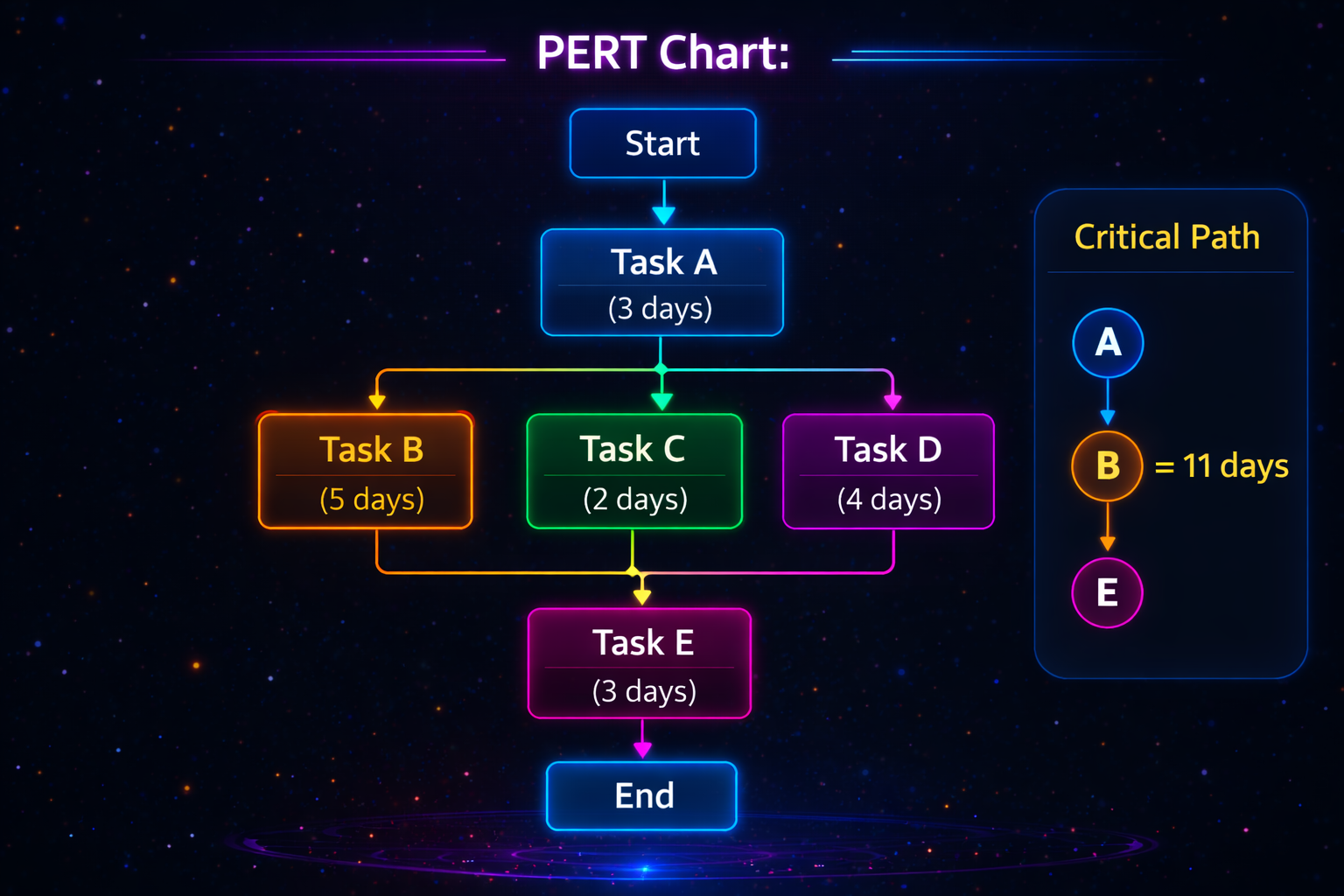

2. PERT Chart (Program Evaluation Review Technique):

Network diagram showing task dependencies.

Notes Image
📊 PERT Chart

Critical Path: Longest sequence of tasks. Delays here delay entire project.

3. CPM (Critical Path Method):

Similar to PERT. Identifies:

  • Critical Path: Tasks that must finish on time (no slack)
  • Slack Time: How much a task can be delayed without delaying project

Example: If Task C takes 2 days but you have 5 days available → 3 days slack.

💡 Why Scheduling Matters:
  • Team knows what to do and when
  • Identifies critical tasks (focus here!)
  • Helps allocate resources efficiently
  • Tracks project progress
  • Warns about potential delays early

2.5 Risk Analysis & Management

📖 Risk: An uncertain event or condition that, if it occurs, has a negative effect on the project (delays, cost overrun, quality issues).

Risk Management: Process of identifying, analyzing, and responding to project risks.
💡 Real-life Example — Outdoor Wedding:

Risk: What if it rains on wedding day?
Risk Management:

  • Identify: Rain is a risk
  • Analyze: Check weather forecast, probability = 30%
  • Impact: High (ruin the event)
  • Mitigation: Book backup indoor venue, rent tent

Types of Software Project Risks:

❌ 1. Technical Risks: Technology problems
• New/unfamiliar technology
• Complex algorithms
• Integration with legacy systems
Example: "We've never used React before — might take longer to learn."
❌ 2. Schedule Risks: Time-related problems
• Unrealistic deadlines
• Task dependencies
• Resource unavailability
Example: "Key developer taking vacation mid-project."
❌ 3. Budget/Cost Risks: Money problems
• Underestimated costs
• Price changes for tools/services
• Unexpected expenses
Example: "Cloud hosting costs more than budgeted."
❌ 4. People/Team Risks: Human resource problems
• Team member quits
• Skill gaps
• Poor communication
Example: "Our only database expert left the company."
❌ 5. Requirements Risks: Unclear/changing requirements
• Scope creep
• Misunderstood requirements
• Client keeps changing mind
Example: "Client wants completely different UI after we built it."

Risk Management Process:

Step 1 — Risk Identification:

List all possible risks. Brainstorm with team, check past projects.

Technique: Checklist, Brainstorming, Interviews, SWOT analysis

Step 2 — Risk Analysis:

For each risk, assess:

  • Probability: How likely? (Low/Medium/High or 0-100%)
  • Impact: How bad if it happens? (Low/Medium/High)
  • Risk Exposure = Probability × Impact
Risk Probability Impact Risk Level
Key developer quits High (70%) High Critical
Minor bug in UI Low (20%) Low Minor
Requirements change Medium (50%) High Major
Step 3 — Risk Mitigation (Planning):

For high-priority risks, create action plans:

  • Avoid: Eliminate the risk (don't use risky technology)
  • Reduce: Lower probability or impact (training, prototyping)
  • Transfer: Shift risk to others (insurance, outsourcing)
  • Accept: Acknowledge risk but do nothing (for low-priority risks)
Step 4 — Risk Monitoring:

Track risks throughout project. Watch for new risks. Update mitigation plans.

💡 Best Practice: Hold weekly risk review meetings. Maintain a risk register (document tracking all risks). Don't ignore small risks — they can become big problems!

2.6 Software Quality & Management

📖 Software Quality: The degree to which software meets its requirements and user expectations. Quality software is correct, reliable, efficient, usable, and maintainable.
💡 Real-life Analogy — Restaurant Quality:

A quality restaurant means:

  • Correctness: You get what you ordered (not wrong dish)
  • Reliability: Food tastes consistent every time
  • Performance: Food arrives quickly
  • Usability: Easy to order, friendly staff
  • Maintainability: Clean, hygienic kitchen

Similarly, quality software meets all these criteria.

Quality Attributes:

✅ 1. Correctness: Software works according to requirements — no bugs.
✅ 2. Reliability: Works consistently without failures over time.
✅ 3. Efficiency: Uses resources (CPU, memory, network) optimally.
✅ 4. Usability: Easy to learn and use. Good user interface.
✅ 5. Maintainability: Easy to fix bugs and add features later.
✅ 6. Portability: Works on different platforms (Windows, Mac, Linux, mobile).

Quality Management Activities:

1. Quality Planning:

Define quality standards and metrics. What does "good quality" mean for this project?

Example: "App must load in under 2 seconds. Crash rate below 0.1%."

2. Quality Assurance (QA):

Process-focused. Ensure the RIGHT processes are followed during development.

  • Code reviews
  • Following coding standards
  • Using version control
  • Regular testing

Goal: Prevent defects by doing things right from the start.

3. Quality Control (QC):

Product-focused. Check if the FINAL product meets quality standards.

  • Testing (unit, integration, system, UAT)
  • Finding and fixing bugs
  • Performance testing
  • Security testing

Goal: Detect and remove defects before release.

Aspect Quality Assurance (QA) Quality Control (QC)
Focus Process Product
Goal Prevent defects Detect defects
When Throughout project After product ready
Example Code reviews, standards Testing, bug fixing

2.7 Software Configuration Management

📖 Configuration Management (CM): A process of systematically managing, organizing, and controlling changes to software artifacts (code, documents, configs) throughout the project lifecycle.
💡 Real-life Analogy — Google Docs Version History:

Remember writing a college assignment:

  • You save versions: assignment_v1.doc, assignment_v2.doc, assignment_final.doc, assignment_final_final.doc
  • Later you want to see what changed between versions
  • You collaborate with groupmates — who changed what?

Google Docs solves this with version history. Similarly, Configuration Management uses tools like Git to track all code changes.

Why Configuration Management?

✅ Track Changes: Know who changed what, when, and why.
✅ Collaboration: Multiple developers work on same codebase without conflicts.
✅ Rollback: If new code breaks something, revert to previous working version.
✅ Parallel Development: Work on new features while maintaining stable version.

Configuration Management Activities:

1. Version Control:

Track changes to code over time. Use tools like Git, SVN.

  • Repository: Central storage for all code versions
  • Commit: Save changes with description
  • Branch: Create separate copy for experiments
  • Merge: Combine changes from different branches

Example: GitHub, GitLab, Bitbucket

2. Change Control:

Manage requests for changes systematically.

  • User/client requests feature or bug fix
  • Change request reviewed by team
  • Assess impact (time, cost, risk)
  • Approve or reject
  • If approved → implement, test, deploy
3. Configuration Audit:

Verify that deliverables match what was agreed upon. Check documentation is updated.

4. Build Management:

Automate process of compiling code, running tests, creating deployable version.

Tools: Jenkins, Travis CI, GitHub Actions

💡 Best Practices:
  • Commit code frequently (at least daily)
  • Write meaningful commit messages ("Fixed login bug" not "changes")
  • Never commit directly to main branch — use feature branches
  • Tag releases (v1.0, v2.0)
  • Back up repositories regularly
❌ Without Configuration Management: Lost code, merge conflicts, can't find bugs introduced, team stepping on each other's work, chaos!
🖥️ Chapter 3 — User Interface Design
🖥️ USER INTERFACE DESIGN — MIND MAP
Good UI Characteristics → Simple, consistent, feedback, forgiving
Command Language → Text commands (CLI) — powerful but requires learning
Menu-Based → Select from list — easy for beginners
Direct Manipulation → Drag & drop, touch — intuitive & visual
Fundamentals → User control, clear language, help & documentation

3.1 What is User Interface (UI)?

📖 Definition: User Interface (UI) is the space where humans interact with computers. It includes everything users see, touch, or hear — screens, buttons, menus, keyboard, mouse, touchscreen.
💡 Real-life Analogy — Car Dashboard:

A car's dashboard is its user interface:

  • Steering wheel: Control direction (input)
  • Speedometer: Shows speed (output/feedback)
  • Buttons: Control AC, music, lights (input)
  • Warning lights: Alert problems (feedback)

You don't need to understand how the engine works — just interact with the dashboard. Similarly, good software UI hides complexity and shows only what users need.

⚠️ Key Point: UI is the ONLY part of software that users see and interact with. If UI is bad, users think the entire software is bad — even if the code is perfect!

3.2 Characteristics of Good User Interface Design

📖 Good UI Design: A user interface that is easy to learn, efficient to use, pleasant, and helps users accomplish their tasks quickly without confusion or errors.

8 Golden Rules of Good UI:

✅ 1. Simplicity: Keep it simple. Don't overwhelm users with too many options.
Example: Google homepage — just a search box. That's it. Simple = powerful.
✅ 2. Consistency: Same actions should work the same way everywhere.
Example: "Back" button should always be in same place. Colors mean same thing throughout app.
✅ 3. Visibility: Important features should be easy to find. Don't hide critical functions.
Example: "Save" button should be visible, not buried in a menu.
✅ 4. Feedback: Tell users what's happening. System should respond to every action.
Example: When uploading file, show progress bar. When button clicked, show it was pressed.
✅ 5. Tolerance (Forgiving): Prevent errors. If errors happen, help users recover easily.
Example: "Are you sure you want to delete?" confirmation. Undo button.
✅ 6. Efficiency: Let experienced users work quickly with shortcuts.
Example: Keyboard shortcuts (Ctrl+S to save), recently used files list.
✅ 7. Memorability: Users should remember how to use it even after not using for a while.
Example: Icons that look like real objects (trash can for delete, printer icon for print).
✅ 8. Clear Language: Use words users understand. No technical jargon.
Bad: "Error 404 - Resource not found"
Good: "Sorry, we couldn't find that page."
❌ Signs of Bad UI:
  • Users can't figure out how to do basic tasks
  • Buttons don't do what users expect
  • No feedback (users don't know if action worked)
  • Can't undo mistakes
  • Cluttered screen with too much information
  • Inconsistent design (buttons look different everywhere)
💡 Real Example — ATM Machine:

Good UI characteristics in ATM:

  • Simple: Clear options (Withdraw, Deposit, Balance)
  • Consistent: "Cancel" button always at same spot
  • Feedback: Shows "Processing..." while working
  • Forgiving: "Are you sure?" before large withdrawals
  • Clear language: "Enter amount" not "Input numerical value"

3.3 Command Language User Interface (CLI)

📖 Command Language Interface: A text-based interface where users type commands to interact with the computer. Also called CLI (Command Line Interface) or Console.
💡 Examples:
  • Windows Command Prompt (CMD)
  • Linux Terminal / Bash
  • Mac Terminal
  • Git commands
Example CLI Commands: $ ls # List files in current directory $ cd Documents # Change to Documents folder $ mkdir myproject # Create new folder $ rm file.txt # Delete file $ git commit -m "fix" # Git commit with message User types command → Press Enter → System executes → Shows result

Advantages of CLI:

✅ Powerful & Flexible: Can do complex tasks with one command.
Example: Delete all .txt files with one command instead of clicking each file.
✅ Fast for Experts: Typing commands is faster than clicking through menus.
✅ Automation: Write scripts to repeat tasks automatically.
✅ Low Resource Usage: No graphics needed — runs on slow/old computers.
✅ Remote Access: Can control computers remotely over network (SSH).

Disadvantages of CLI:

❌ Hard to Learn: Must memorize commands and syntax. No visual clues.
❌ Not Beginner-Friendly: Scary black screen with blinking cursor. No menus to guide.
❌ Easy to Make Mistakes: One typo = command fails or does wrong thing (dangerous with delete commands!).
❌ No Visual Feedback: Hard to see results of complex operations.
💡 When to Use CLI: System administration, developers/programmers, automation tasks, servers without GUI, power users who want speed.

3.4 Menu-Based User Interface

📖 Menu-Based Interface: A UI where users select options from a list of choices (menus). Users navigate by clicking or pressing numbers/keys corresponding to menu items.
💡 Real-life Analogy — Restaurant Menu:

At a restaurant, you pick from a menu:

  • See all available options
  • Choose what you want
  • Don't need to remember names of dishes
  • Can browse before deciding

Software menu is similar — shows available actions, user picks one.

Example Menu Interface: ===== Main Menu ===== 1. File 2. Edit 3. View 4. Help 5. Exit Enter choice (1-5): 1 ===== File Menu ===== 1. New 2. Open 3. Save 4. Close 5. Back to Main Menu Enter choice (1-5): _

Types of Menus:

1. Pull-down Menus: Click menu name → list drops down.
Example: File, Edit, View menus in Microsoft Word.
2. Pop-up Menus: Right-click → menu appears at cursor position.
Example: Right-click on desktop → see options like "Refresh", "Properties".
3. Hierarchical Menus: Main menu → submenu → sub-submenu.
Example: Start Menu → Programs → Microsoft Office → Word.
4. Linear Menus: Simple numbered list (like ATM).
Example: "Press 1 for Balance, 2 for Withdraw, 3 for Deposit".

Advantages of Menu-Based UI:

✅ Easy for Beginners: See all options — no need to memorize commands.
✅ Less Training Needed: Self-explanatory — users can explore.
✅ Reduces Errors: Can only pick from valid options — can't make typos.
✅ Predictable: Users know what options exist.

Disadvantages of Menu-Based UI:

❌ Slow for Experts: Clicking through menus is slower than typing commands.
❌ Too Many Menus = Confusing: Deep hierarchies (7 levels deep) frustrate users.
❌ Limited Flexibility: Can only do what's in the menu — no custom actions.
💡 When to Use Menus: Applications for general users, kiosks, ATMs, mobile apps, systems where users don't need training.

3.5 Direct Manipulation Interfaces

📖 Direct Manipulation: A UI style where users interact with objects on screen directly — dragging, dropping, resizing, touching. Objects look and behave like real-world counterparts. What You See Is What You Get (WYSIWYG).
💡 Real-life Analogy — Playing with Toys:

A child playing with toy blocks:

  • Picks up block (drag)
  • Places it somewhere (drop)
  • Sees immediate result
  • If mistake → just move block again

No commands needed. Just touch and manipulate. Direct manipulation UI works the same way!

💡 Examples of Direct Manipulation:
  • Desktop Icons: Drag file to trash can to delete
  • Touchscreen: Pinch to zoom, swipe to scroll
  • Graphic Editors: Drag corner of image to resize
  • Games: Click and drag character to move
  • Map Apps: Drag map around, drop pin on location

Principles of Direct Manipulation:

✅ 1. Continuous Representation: Objects always visible on screen (not hidden in menus).
✅ 2. Physical Actions: Use mouse/finger to directly act on objects (drag, click, touch).
✅ 3. Rapid Feedback: Actions show results immediately (not after pressing "OK").
✅ 4. Reversible: Easy to undo actions (Ctrl+Z, shake phone to undo).

Advantages of Direct Manipulation:

✅ Intuitive & Natural: Feels like manipulating real objects. Easy to learn.
✅ Visual & Engaging: Users see what they're doing — more satisfying.
✅ Immediate Feedback: Results appear instantly — users stay in control.
✅ Less Training: Exploration-based learning — try things and see what happens.
✅ Low Error Rate: See effects before confirming — can cancel if wrong.

Disadvantages of Direct Manipulation:

❌ Screen Space: Needs large display — objects must be visible. Doesn't work well on small screens.
❌ Slow for Complex Tasks: Dragging 1000 files one by one is tedious. CLI command would be faster.
❌ Not Good for Blind Users: Relies on visual + mouse/touch. Screen readers can't describe drag-drop actions well.
❌ Hard to Automate: Can't script direct manipulation actions easily.
💡 When to Use Direct Manipulation: Graphic design tools, games, mobile apps, CAD software, anything visual or creative.

3.6 Comparison: CLI vs Menu vs Direct Manipulation

CLI vs Menu vs Direct Manipulation Comparison
💡 Hybrid Approach (Best Practice):
Modern software combines all three!

Example: Microsoft Word has menus (File, Edit),
direct manipulation (drag text),
AND keyboard shortcuts (CLI-like).
Users choose what they prefer!
⚡ Ready for Exam? Sab padh liya? Ab Quick Revision karo — formulas, key points aur exam tips ek jagah! Quick Revision Karo →
⚡ Quick Revision — Last Minute Exam Prep!
📌 How to use: Read this 15 minutes before exam. Includes definitions, tricks, formulas, examples — everything you need!

🎨 Chapter 1 — Software Design

📖 What is Software Design?
Transforming requirements into implementable structure. Like creating a blueprint before building a house.

💡 Trick: Requirements → Design → Code
Example: Client says "I want login" → You design Login module (inputs, outputs, database) → Then code it
🔄 Design Process (6 Steps):
1. Understand requirements
2. Identify modules
3. Define interactions
4. Design data structures
5. Design algorithms
6. Create documentation

Exam Tip: Always draw a diagram showing modules!
✅ Core Design Concepts (Remember "ACMCR"):
A - Abstraction = Hide complexity
C - Cohesion = HIGH is good (module does ONE thing)
M - Modularity = Break into parts
C - Coupling = LOW is good (independent modules)
R - Refinement = Top-down, add details gradually

⚠️ Common Mistake: Students confuse High Cohesion vs Low Coupling!
Remember: HIGH quality INSIDE module, LOW dependency BETWEEN modules
💡 Modular Design — Quick Points:
What: Break system into independent modules
Example: Netflix = Login module + Streaming module + Payment module
Benefits (Remember "TERMS"):
• Testable - Test each separately
• Easy to maintain
• Reusable - Use in other projects
• Multiple teams can work parallel
• Simple to understand

Good Module = High Cohesion + Low Coupling + Clear Interface
Design Model (4 Types):

1. DATA Design → Database structure
Example: Tables for Users, Products, Orders

2. ARCHITECTURAL → Big picture structure
Example: Frontend ↔ Backend ↔ Database

3. INTERFACE → How modules interact
Example: Function signatures, APIs

4. COMPONENT-LEVEL → Detailed module logic
Example: Login module internal algorithm

Exam Pattern: "Explain Design Model" = Define all 4 types + 1 example each
📐 Design Approaches (Table Trick):
Approach Focus Language Use
Structured Functions C Small projects
Object-Oriented Classes/Objects Java Large projects
Component-Based Reusable parts React Web apps

📊 Chapter 2 — Project Management

📋 Project Planning Essentials:
Remember "SORTED":
Scope - What's in/out?
Objectives - What to achieve?
Resources - People, tools, money
Tasks - WBS (Work Breakdown Structure)
Estimate - Time & cost
Delegate - Assign responsibilities

Real Analogy: Like planning a road trip → Destination, route, budget, who's driving

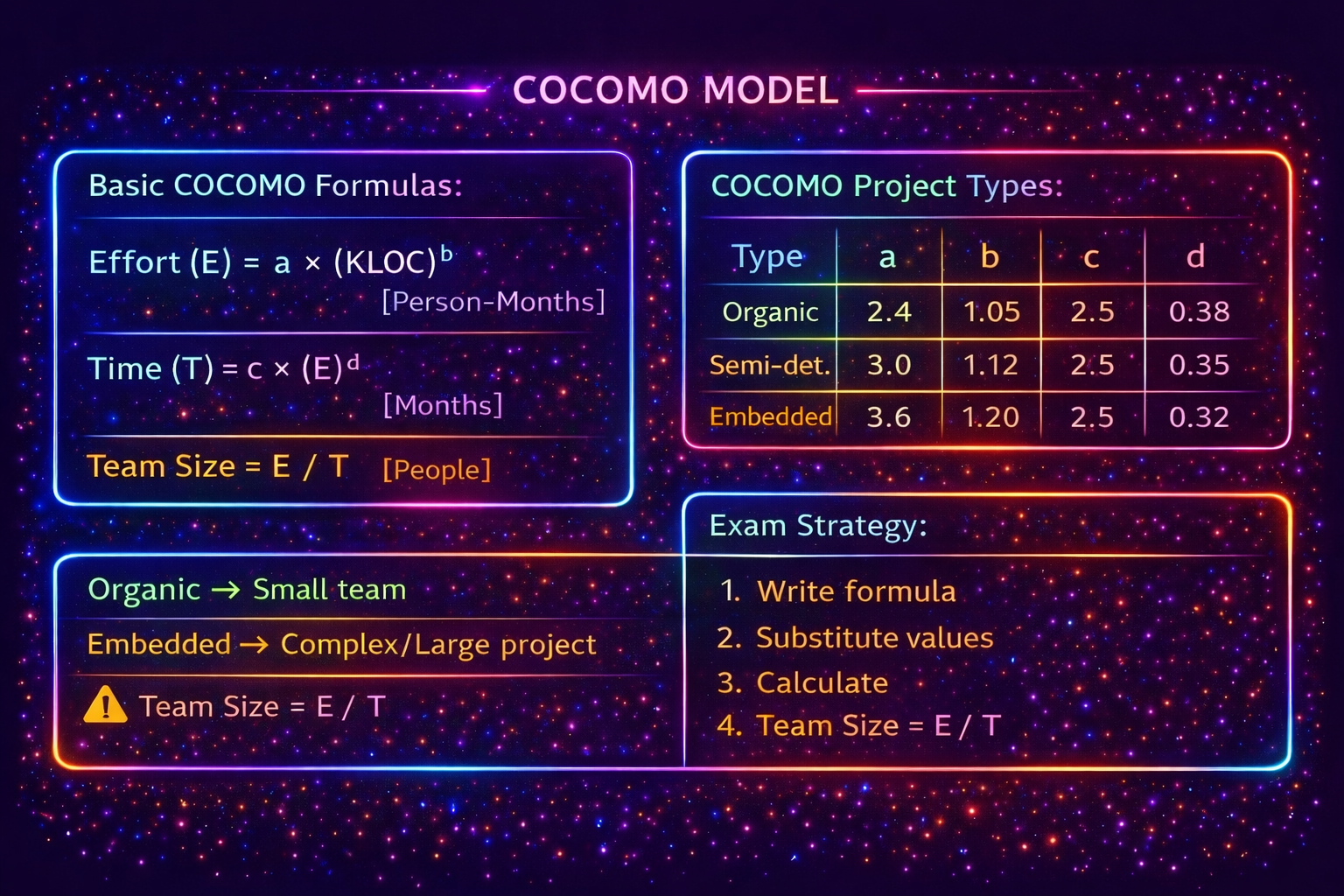

COCOMO Model
💡 Solved Example (Practice This!):
Q: Organic project, 25 KLOC. Find Effort, Time, Team.
Solution:
Given: Organic → a=2.4, b=1.05, c=2.5, d=0.38, KLOC=25

E = 2.4 × (25)^1.05 = 2.4 × 27.14 = 65 PM
T = 2.5 × (65)^0.38 = 2.5 × 4.64 = 11.6 months
Team = 65/11.6 = 5-6 people
📅 Scheduling Tools (Quick Compare):

Gantt Chart: Bar chart → Shows timeline → Easy to understand
PERT Chart: Network diagram → Shows dependencies → Finds critical path
CPM: Like PERT → Identifies critical path (longest path)

Critical Path = Longest path = Delays here = Project delays
Slack Time = How much delay OK without affecting project
⚠️ Risk Management (4 Steps - "IAMM"):
Identify risks → List all possible problems
Analyze → Probability × Impact = Risk Exposure
Mitigate → Avoid/Reduce/Transfer/Accept
Monitor → Track throughout project

5 Risk Types (Remember "TSBPR"):
Technical, Schedule, Budget, People, Requirements

Exam Trick: Always mention Risk Exposure = P × I
✅ QA vs QC (Never Confuse!):
QA QC
Focus Process Product
Goal PREVENT bugs DETECT bugs
When Throughout After product ready
Example Code reviews Testing
Mnemonic: QA = Quality Assurance = PREVENT (proactive)
QC = Quality Control = DETECT (reactive)
🔧 Configuration Management:
What: Managing code changes systematically
Tool: Git (most common)
Key Terms:
• Repository = Central code storage
• Commit = Save changes
• Branch = Separate copy for features
• Merge = Combine branches

Why Important: Track changes, collaboration, rollback, parallel development

🖥️ Chapter 3 — User Interface Design

✨ Good UI — 8 Golden Rules (Remember "SCVFTEMM"):
Simplicity - Keep it simple (Google homepage)
Consistency - Same actions work same way
Visibility - Important features easy to find
Feedback - Tell users what's happening (progress bars)
Tolerance - Forgiving, allow undo
Efficiency - Shortcuts for experts
Memorability - Easy to remember
Meaningful language - No jargon

Example: ATM = Simple options, consistent layout, feedback ("Processing"), forgiving ("Are you sure?")
Interface CLI Menu Direct Manipulation
Input Type commands Select from list Drag, drop, touch
Learning Hard Easy Very Easy
Speed Very Fast Medium Medium
Errors High Low Low
Example Terminal ATM Touchscreen
Best For Developers General users Creative apps
💡 Quick Examples to Remember:

CLI: Linux Terminal - Type "ls" to list files
Pros: Fast, powerful | Cons: Must memorize commands

Menu-Based: Restaurant menu - Choose from options
Pros: Easy for beginners | Cons: Slow for experts

Direct Manipulation: Drag file to trash
Pros: Intuitive, visual | Cons: Needs screen space

Exam Tip: Comparison questions = Always make a table!

🎯 Last Minute Exam Strategy

❌ TOP 5 Mistakes Students Make:
1. COCOMO: Calculating E and T but forgetting Team Size
2. Cohesion/Coupling: Writing High Coupling is good (IT'S NOT!)
3. QA vs QC: Using terms interchangeably
4. UI Comparison: Not making a table when asked to compare
5. Design Process: Forgetting to draw diagrams
✅ 2 Mark Questions Strategy:
• Definition (1 line) + Example (1 line) = Full marks
• "List two" = Write EXACTLY 2, not more
• Keep it short — 4-5 lines maximum
• Use bullet points if listing

Example:
Q: Define Cohesion.
Ans: Cohesion measures how focused a module is. High cohesion means module does ONE thing well. Example: A Login module should ONLY handle login, not payment.
✅ 5 Mark Questions Strategy:
• Definition + Types/Steps + Diagram + Example = 5 marks
• COCOMO Numerical: Show ALL steps with formulas
• Comparison: Always draw a table
• Explain: Use subheadings (Benefits:, Disadvantages:)
• Draw diagrams wherever possible (PERT chart, module structure)

Time Management: 2M = 3 mins, 5M = 8 mins
🔥 MUST REVISE (High Priority Topics):
  1. COCOMO Model (GUARANTEED numerical)
  2. Good UI Characteristics (8 rules)
  3. CLI vs Menu vs Direct Manipulation (Table)
  4. Risk Management 4 steps
  5. QA vs QC difference
  6. Modular Design benefits
  7. Design Process 6 steps
  8. Cohesion vs Coupling
  9. PERT/CPM Critical Path
  10. Configuration Management (Git)
Practice Questions:
  • Solve 1 COCOMO numerical NOW
  • Draw PERT chart example
  • Make UI comparison table from memory
💡 Power Mnemonics (Use These!):
  • Design Concepts: ACMCR (Abstraction, Cohesion, Modularity, Coupling, Refinement)
  • Planning: SORTED (Scope, Objectives, Resources, Tasks, Estimate, Delegate)
  • Risk Steps: IAMM (Identify, Analyze, Mitigate, Monitor)
  • Risk Types: TSBPR (Technical, Schedule, Budget, People, Requirements)
  • Good UI: SCVFTEMM (Simplicity, Consistency, Visibility, Feedback, Tolerance, Efficiency, Memorability, Meaningful)
  • Modular Benefits: TERMS (Testable, Easy, Reusable, Multiple teams, Simple)
📄 Previous Year Questions

Section A — 2 Marks Questions (Short Answer)

2M PYQ 2024-25
Q1. List the major responsibilities of a software project manager. ▼
Answer:
1. Project Planning: Estimating cost, time, and resources (using COCOMO).
2. Scheduling: Creating Gantt/PERT charts and assigning tasks.
3. Risk Management: Identifying potential problems and planning solutions.
2M PYQ 2024-25
Q2. Classify different types of couplings and their impact on Software Design. ▼
Answer:
Types from Best to Worst:
1. Data Coupling (Best): Modules only pass necessary data.
2. Stamp Coupling: Passing whole data structures instead of specific data.
3. Control Coupling: One module controls the execution flow of another.
4. Content Coupling (Worst): Modules modify each other's code. Highly impacts design negatively.
2M PYQ 2024-25
Q3. List four fundamental principles of a good user interface design. ▼
Answer:
1. User Familiarity: Use concepts users already know (e.g., folder icon for files).
2. Consistency: Buttons and colors should mean the same thing everywhere.
3. Minimal Surprise: System should behave exactly as the user expects.
4. Recoverability: Let users easily undo mistakes (Ctrl+Z).
2M PYQ 2024-25
Q4. How does software verification differ from Software Validation? ▼
Answer:
Verification: "Are we building the product right?" (Checking if code follows the design).
Validation: "Are we building the right product?" (Checking if the final software meets customer requirements).
2M PYQ 2024-25
Q5. For 'Semi-Detached' Project Estimated Size '100 KLOC', calculate effort & time. ▼
Answer:
For Semi-Detached: a = 3.0, b = 1.12, c = 2.5, d = 0.35
1. Effort (E): a * (KLOC)^b = 3.0 * (100)^1.12 = 3.0 * 173.78 = 521.34 Person-Months
2. Time (D): c * (E)^d = 2.5 * (521.34)^0.35 = 2.5 * 8.92 = 22.3 Months
2M PYQ 2025-26
Q6. Name the two types of documents produced during the design phase. ▼
Answer:
1. HLD (High-Level Design): Defines the overall architecture and modules of the system.
2. LLD (Low-Level Design): Defines the detailed logic, algorithms, and data structures for individual modules.
2M PYQ 2025-26
Q7. How good software design contributes to software quality? ▼
Answer:
1. A good design makes the software easy to understand and modify, improving maintainability.
2. It reduces bugs and errors during coding by providing a clear blueprint, improving reliability.
2M PYQ 2025-26
Q8. Define coupling and cohesion. State their impact on software maintainability. ▼
Answer:
Cohesion: How closely related the functions inside a single module are. (Should be HIGH).
Coupling: How strongly different modules depend on each other. (Should be LOW).
Impact: High cohesion and low coupling make modules independent, meaning changes in one module don't break others, making maintenance extremely easy.
2M PYQ 2025-26
Q9. Identify any two project scheduling tools. ▼
Answer:
1. Gantt Charts: Horizontal bar charts showing task durations and overlap.
2. PERT Charts (Program Evaluation Review Technique): Network diagrams showing dependencies between tasks.
2M PYQ 2025-26
Q10. State any two benefits of modular software design. ▼
Answer:
1. Reusability: A module written once can be reused in different programs.
2. Parallel Development: Different teams can work on different modules simultaneously, speeding up development.

Section B — 5 Marks Questions (Long Answer)

5M PYQ 2024-25
Q11. For 100 KLOC Organic System, calculate effort & time. Re-calculate if changed to Semi-Detached. Provide Analysis. ▼
Answer:
Case 1: Organic (a=2.4, b=1.05, c=2.5, d=0.38)
Effort = 2.4 * (100)^1.05 = 2.4 * 125.89 = 302.14 PM
Time = 2.5 * (302.14)^0.38 = 2.5 * 8.87 = 22.1 Months

Case 2: Semi-Detached (a=3.0, b=1.12, c=2.5, d=0.35)
Effort = 3.0 * (100)^1.12 = 3.0 * 173.78 = 521.34 PM
Time = 2.5 * (521.34)^0.35 = 2.5 * 8.92 = 22.3 Months

Analysis:
Semi-Detached requires vastly more effort (521 vs 302 PM) because the difficulty and complexity of the project increased, requiring more skilled engineers, though the time duration remains roughly the same due to adding more people in parallel.
5M PYQ 2024-25
Q12. Demonstrate different types of cohesion with suitable examples. ▼
Answer:
Cohesion is how tightly bound the elements within a module are. Types from Worst to Best:

1. Coincidental (Worst): Random tasks grouped together. Example: A module containing `Print_Report()` and `Calculate_Tax()` with no relation.
2. Logical: Tasks grouped logically, like all error handlers. Example: `Handle_All_Errors()`.
3. Temporal: Linked by time of execution. Example: `System_Startup()` loading DB, UI, and network config.
4. Procedural: Grouped to follow a specific sequence. Example: `Check_File()`, then `Read_File()`.
5. Functional (Best): Module performs exactly ONE single task perfectly. Example: `Calculate_Employee_Salary()`.
5M PYQ 2025-26
Q13. Project: Organic type, Size: 60 KLOC. Use Basic COCOMO to compute Nominal Effort and Development Time. ▼
Answer:
For Organic Type: a = 2.4, b = 1.05, c = 2.5, d = 0.38

1. Nominal Effort (E):
E = a * (KLOC)^b
E = 2.4 * (60)^1.05
E = 2.4 * 72.84 ≈ 174.8 Person-Months

2. Development Time (D):
D = c * (E)^d
D = 2.5 * (174.8)^0.38
D = 2.5 * 7.15 ≈ 17.8 Months
5M PYQ 2025-26
Q14. Discuss how UI design decisions influence system usability, user satisfaction, and software acceptance. ▼
Answer:
UI is the only part of the software the customer directly interacts with, acting as the bridge between human and machine.

1. Usability: A clear design with familiar icons reduces learning time. If a user can perform tasks without training, usability is high.
2. User Satisfaction: Consistent layouts (like "Back" button always on top left) make users feel in control. Confusing UI frustrates users, making them abandon the software.
3. Software Acceptance: Even if the backend code is perfect and complex, a terrible, ugly UI will cause the client to reject the product.

Example: Why is Google Search so successful? Because its UI is literally just one simple text box!
